-
A Project Update: January 2026
Share A Project Update: January 2026 on Facebook Share A Project Update: January 2026 on Twitter Share A Project Update: January 2026 on Linkedin Email A Project Update: January 2026 link
Project Status Update
Where we’re at
Construction at the new Dawson Creek & District Hospital continues to move forward steadily. On the outside, work on the building’s cladding and louvers is progressing well and helping bring the exterior closer to completion.
Inside, crews are making strong progress on drywall, mudding, taping, painting, and wall protection in all areas of the building. On Levels 1 and 2, painting is finished, wall protection is about 81% complete, and flooring installation is roughly 75% complete. Many interior spaces are now moving into later finishing stages, including the installation of fixtures, finishes, and acoustical ceiling tiles. Doors and hardware are also being added throughout the early‑completed zones.
A major milestone was reached in January with the startup of the Air Handling Units, an important step toward bringing building systems online. Mechanical work is progressing throughout the facility, with commissioning activities happening in some areas and rough‑ins continuing in others. Electrical crews are advancing equipment setup and pre‑commissioning, as well as running cable and completing hook‑ups in upper mechanical spaces. Another sign of progress is that permanent lighting is now being energized in some parts of the building.
Furniture planning and procurement are also underway, with Contemporary Office Interiors engaged to supply furnishings for the new hospital.
What’s next
In the months ahead, construction teams will continue working toward completing the exterior cladding and louvers. Inside the building, work will continue on drywalling, painting, flooring, and other finishing work as more areas move into the later stages of completion. Installation of fixtures, finishes, doors, and ceiling tiles will also continue as additional spaces near completion.
Mechanical commissioning will progress on Level 0, while mechanical and electrical rough‑ins and equipment installation will carry on in the penthouse mechanical room. Electrical crews will keep completing hook‑ups, cable pulls, and work in satellite electrical rooms as permanent power is extended to more areas. Procurement of equipment and furniture will also continue as the project moves closer to operational readiness.
Looking ahead, an RFP will be issued in January 2026 for Professional Engineering Services to prepare abatement and demolition documents for the existing hospital. An additional RFP will be issued for a Food and Beverage Contractor to operate the café in the new facility.
Fun facts! Did you know?
The new Dawson Creek & District Hospital is a major infrastructure project, and its scale can be better appreciated when compared to familiar landmarks from our region:
- The new facility includes 1,060 door slabs. If laid end-to-end horizontally, they’d stretch about 64% of the Dawson Creek Airport runway. Flip them upright? They’d be nearly 1.4 times the runway length!
- There will be 86 interior windows – enough to match two full rounds of Dawson Creek’s 40-stop Heritage Walking Tour, with a few extra stops to spare.
- The plumbing system moves 22,712 L of water every day – that’s just over 2% of the Kenn Borek Aquatic Centre’s 990,000 L lap pool, 2.5 times the tots’ pool and nearly twice the hot tub.
- Dawson Creek has 520 public fire hydrants, and the new hospital will have 402 sinks – about 77% of the city’s hydrant count.
- The new hospital will have 717 medical gas outlets – enough to care for roughly 16% of a sold‑out hockey crowd or about 11% of a full concert audience at the Ovintiv Events Centre.

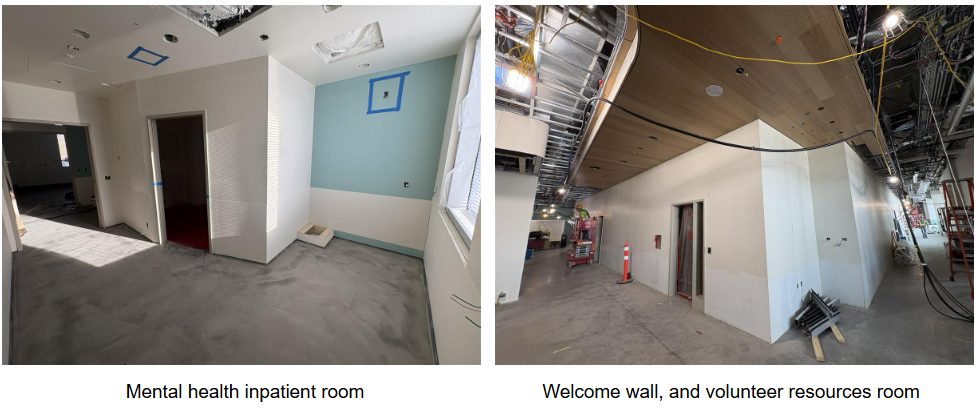

Construction Progress Photos

Coming soon! A virtual look inside the new hospital!
Wondering what’s happening inside the new hospital? We know there’s a lot of excitement and curiosity about what the inside looks like—and we’re thrilled to start sharing it with you in the coming months. As interior finishes near completion, we will be creating short virtual video tours of departments and key spaces, offering a first look at areas as they come to life.
These sneak‑peek tours will be shared with staff and physicians and featured on Let’s Talk DCDH as well as Northern Health’s YouTube and social media channels. As we continue to approach substantial completion and opening day, watch for more videos as new zones are completed!
Frequently Asked Questions
How many parking stalls? Will it remain free?
We know parking is important to you! Whether you’re visiting a loved one, coming in for an appointment, or working a shift, having convenient and accessible parking makes a big difference.
The new hospital will feature 311 parking stalls—over 100 more than the current hospital—including 125 stalls for staff and physicians and 186 stalls for patients and visitors. In addition, there are 16 accessible parking stalls, drop‑off zones at the main and emergency entrances, 66 bike racks, 8 electric vehicle stalls, dedicated RCMP parking, and motorcycle parking.
And mostly importantly, parking will remain free for everyone!
What will happen to the current hospital?
Many residents have been wondering what will happen to the current hospital once the new hospital opens. The current DCDH was built in 1960 in accordance with clinical health care services and building code standards at the time. Since then, standards have continuously evolved and improved. Recognizing these changes, the current hospital doesn’t align with current clinical and patient care standards and doesn’t comply with the current BC Building Code.
While some may wonder if the newer section of the current hospital could be retained, this is not feasible. The newer section also does not meet today’s clinical and patient care standards and cannot operate independently. It relies heavily on the older portion of the building for essential mechanical and electrical infrastructure. Key services such as the Emergency Department, Medical Imaging, and Laboratory are interconnected with systems housed in the older section. There is no practical way to sustain only one part of the building without the supporting infrastructure.
Once the new hospital is open and operational, the current hospital will become inactive, be emptied out and then removed. This step is part of the approved Business Plan, which includes a full abatement process before demolition. We will be hiring a consultant to prepare materials related to the abatement and demolition of the existing hospital using a procurement process. Following that, a tender process will be held to engage a construction firm to undertake the scope of work. The abatement and demolition of the existing hospital is targeted to take place once the new hospital is open and operational in early 2027.
After abatement and removal of the existing facility, the site will be cleared and turned back into developable land for potential future use.
Operational Readiness and Transition Planning
Monthly departmental workplan meetings were held in November and December, with programs continuing to demonstrate steady and healthy progress toward completion of their operational planning deliverables. These sessions remain an important forum for addressing risks and ensuring alignment across clinical and non-clinical teams as planning advances.
The fifth Operational Readiness Committee (ORC) meeting was held in November, with focused discussion on the Risk Register, Change Requests, and Opening Day Views. The committee also initiated preparatory work for 2026, including early planning related to staff orientation, training, and simulation activities to support a safe and coordinated opening.
Collaboration continues with IMIT to support readiness of clinical system integrations, and with Health Care Relocations (HCR) to advance development of a detailed Patient Transition Plan that prioritizes patient safety, continuity of care, and clear communication across services.
HCR onboarded for move to new facility
Preparations are well underway to ensure a smooth and safe transition into the new facility. To support this effort, Health Care Relocations (HCR)—a global leader in hospital move management—has officially been onboarded. With more than three decades of experience and over 500 successful relocations worldwide, HCR brings specialized expertise in planning, coordinating, and executing complex hospital moves while keeping patient care at the centre of every decision.
In December, the HCR team visited Dawson Creek to meet with leaders, tour each department, and begin assessing what equipment will move, what should be replaced, and how best to sequence relocations to minimize downtime. Over the coming months, they will develop detailed move plans, including a comprehensive move calendar and an information guide to help staff stay informed and prepared.
Staff engagement will be a key component of the transition. Each department will appoint a Department Move Coordinator to participate in planning, review equipment lists, and provide operational insights. A Patient Transfer Committee will also be established to design transfer day procedures, create patient information resources, and ensure roles and responsibilities are clearly defined. All of this planning will help ensure that, when move day arrives, patients are transferred with care, dignity, and clear communication—setting the stage for a safe and successful opening of the new hospital.
Inventory of artworks and artefacts in current hospital
As part of preparations for the transition to the new hospital, an inventory of all existing artworks, art pieces, and cultural artefacts currently displayed in the hospital is underway. This work will help document each item, identify ownership, and support decisions about which pieces may be transferred to the new facility.
We recognize that many of these pieces hold deep historical and emotional meaning for staff, physicians, and the community. Opportunities will be built into the new hospital to preserve and reflect the history of the current facility, supported by a dedicated art budget and guidance from a project Art Committee with local and regional representation. Items not transferring to the new hospital will be handled with care, with efforts made to return them to their original artists, donors, owners, or families.
Engagement Initiatives
Dawson Creek Job Fair
Representatives from the DCDH project team alongside Byron Stewart, Northeast Recruitment and Retention Ambassador recently attended the Dawson Creek Job Search and Support Services and Outlines for Life Society Job Fair at the Kiwanis Performing Arts Center.
Together, we engaged with job seekers, community members, and local service organizations to share information about:
- Current career opportunities with Northern Health
- How to create an online profile on the NH Careers portal
- Upcoming hiring needs for the new Dawson Creek & District Hospital
Our booth welcomed steady interest throughout the event, with many attendees expressing enthusiasm for future opportunities at the new hospital. This job fair provided a valuable platform for raising awareness about Northern Health careers and building connections with potential applicants.
Other Exciting News
Calling artists: Exterior sculpture opportunity
Northern Health invites artists to submit an Expression of Interest (EOI) for the design and fabrication of an exterior sculpture to be featured outside the Emergency Department entrance of the new Dawson Creek & District Hospital.
This sculpture will serve as a meaningful landmark for patients, families, staff, and the community. The sculpture will symbolize the values of health, healing, and community while reflecting the unique identity of the Peace Region.
The EOI period is open until Friday, March 6 at 5:00 PM MST. Download a copy of the EOI document.
A bright welcome: Tuscan Sun panels complete the hospital’s exterior
The new hospital has reached an eye‑catching milestone with the installation of its Tuscan Sun aluminum composite panels, now visible across much of the city. These golden panels complete the hospital’s bold exterior colour palette and were intentionally chosen to be warm and welcoming and to complement the City of Dawson Creek’s logo.
Positioned at the main entrance, the panels add a bright contrast to the soon‑to‑be‑installed “H” sign, helping guide visitors into the facility. As one of the tallest structures in Dawson Creek, the hospital’s completed exterior now reflects regional identity through its colours of Ocean Blue, Lagoon, and Tuscan Sun.
Dawson Creek & District Hospital Foundation launches $3 Million campaign to bring an MRI to the new hospital
The Dawson Creek & District Hospital Foundation’s “Create a Clear Picture” campaign is well underway, aiming to raise $3 million to bring the first publicly funded MRI machine to the new Dawson Creek & District Hospital. This vital service will ensure patients can access advanced diagnostic imaging closer to home, reducing travel, shortening wait times, and helping improve overall health outcomes.
The campaign received a significant boost with ARC Resources Ltd. stepping forward as the lead donor, contributing an impressive $1.5 million towards the campaign. This major investment reflects strong community leadership and deep regional commitment to improving access to modern healthcare. ARC emphasized that supporting this initiative ensures residents can receive timely, high‑quality care while remaining in their own community.
The Foundation invites individuals, businesses, and community partners to join this effort and help create a healthier future for all. To learn more, visit the Dawson Creek & District Hospital Foundation’s website.
Featured Stories
- FAQ: Parking at the new hospital
- A bright welcome: Tuscan Sun panels complete the hospital’s exterior
- FAQ: What's going to happen to the current DCDH?
- Dawson Creek & District Hospital Foundation Announces Lead Donor for MRI Campaign
- Dawson Creek & District Hospital Foundation launches $3 Million campaign to bring an MRI to the new hospital
- A Project Update: October 2025
- Expression of Interest - Retail Food and Beverage Services
- Quarterly Update - October 2025 [PDF]
- Monthly labour report - As of October 31, 2025 [PDF]
- Monthly labour report - As of November 30, 2025 [PDF]
- Monthly labour report - As of December 31, 2025 [PDF]
- Construction Camera Timelapse - October 2025 [VIDEO]
- Construction Camera Timelapse - November 2025 [VIDEO]
- Ocean Blue and Lagoon ACM panel reveal [VIDEO]
- Tuscan Sun ACM panel reveal [VIDEO]
- Construction Camera Timelapse - December 2025 [VIDEO]
Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks -
Calling Artists! Exterior Sculpture – Expression of Interest
Share Calling Artists! Exterior Sculpture – Expression of Interest on Facebook Share Calling Artists! Exterior Sculpture – Expression of Interest on Twitter Share Calling Artists! Exterior Sculpture – Expression of Interest on Linkedin Email Calling Artists! Exterior Sculpture – Expression of Interest link
Download a copy of the EOI document here
Northern Health invites artists to submit an Expression of Interest (EOI) for the design and fabrication of a sculpture to be featured outside the Emergency Department entrance of the new Dawson Creek & District Hospital.
This sculpture will serve as a meaningful landmark for patients, families, staff, and the community. The sculpture will symbolize the values of health, healing, and community while reflecting the unique identity of the Peace Region.

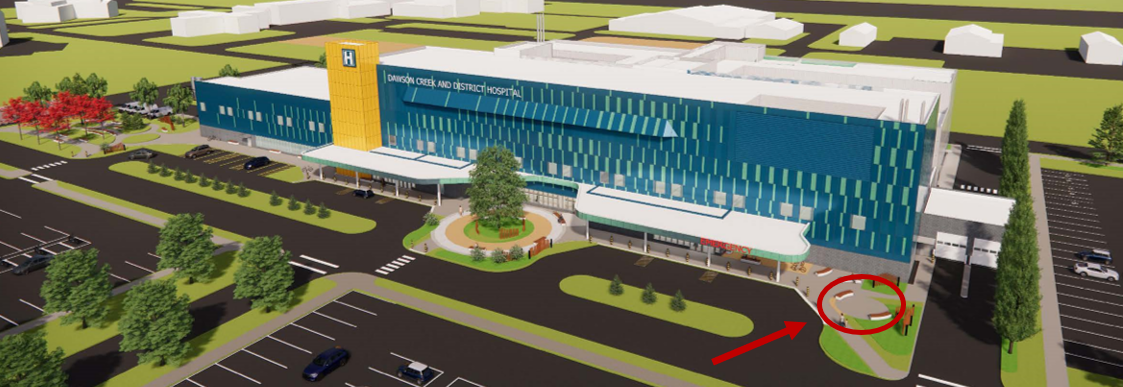

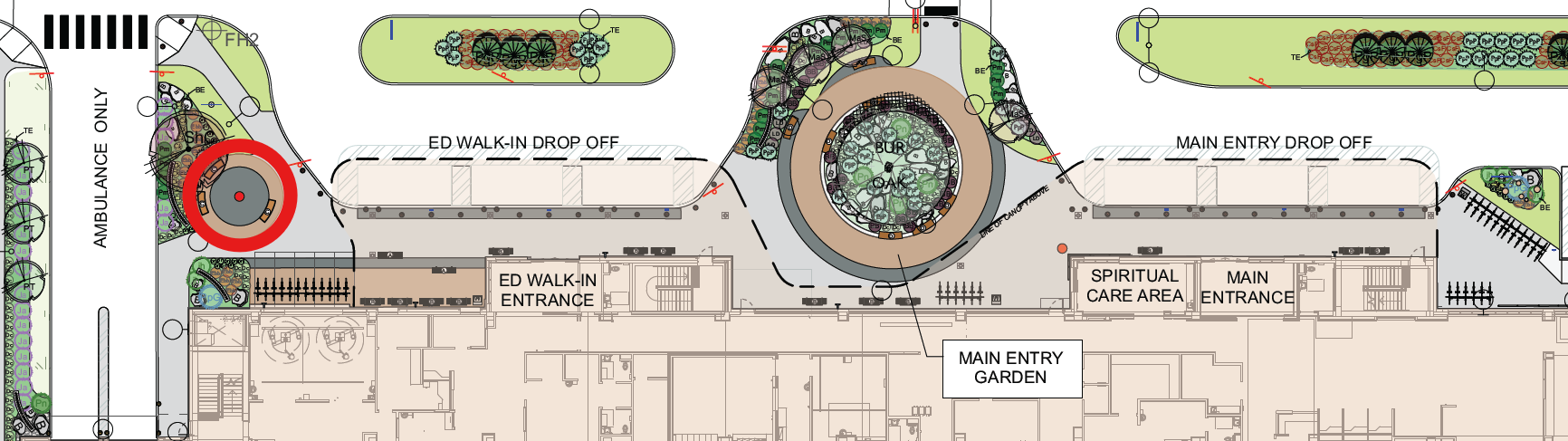

Planned location for exterior sculptureSUBMISSION REQUIREMENTS:
Artists are encouraged to consider themes such as:
- Commemorating the legacy of the old hospital or symbolizing a new beginning
- Representing stories, cultural or historical symbols, and regional aspects
- Integrating Indigenous culture and perspectives
- Serving as a landmark, tribute, or storytelling piece
Artists are asked to submit the following:
- Artist resume – Detailing professional training and/or experience.
- Portfolio with examples of similar works – Images and descriptions of past relevant projects.
- Proposed concepts or draft designs – Detailed enough to understand your vision, artistic approach, and technical considerations.
BUDGET AND PHASING:
The budget for this project is $30,000, and is all inclusive of the artist’s fees, labour, supplies, materials, prep, etc. This will be distributed as follows:
-
Phase 1 – Design phase:
- $10,000 upon approval of the final design.
-
Phase 2 – Fabrication phase:
- $15,000 upon fabrication completion prior to delivery and installation.
-
Phase 3 – Installation phase
- $5,000 upon delivery and installation.
- Please note: Graham (the Design-Builder) is responsible for installation of the sculpture, in coordination with the artist. The artist is expected to attend an unveiling ceremony.
DESIGN CONSIDERATIONS:
-
There is a 200 mm (8") reinforced concrete slab on grade provided with a base bearing area of approximately 1m in diameter.
- Smaller base areas may reduce allowable weight.
- An electrical circuit and power feed for lighting will be provided.
-
Weight & aspect ratio limits:
- For 2:1 or less height-to-base ratio: max 7,500 lbs (33 kN)
- For 3:1 ratio: max 5,000 lbs (22 kN)
- For 4:1 ratio: max 2,800 lbs (13 kN)

SELECTION CRITERIA:
Submissions will be evaluated by the DCDH Replacement Project’s Art Committee, Steering Committee, Project Management Team, and local hospital leadership.
Evaluation and selection criteria will be based on:
- Artistic merit and originality
- Alignment with community values and themes
- Feasibility within structural and site constraints
- Ability to reflect regional identity and Indigenous culture
LEGAL INFORMATION:
The successful artist will be required to enter into a written agreement with Northern Health that outlines the scope of work, deliverables, timelines, payment schedule, and other standard terms and conditions. Selection through this Expression of Interest does not constitute a contract.
Northern Health reserves the right to photograph and reproduce images of the sculpture for non‑commercial purposes. Northern Health will provide standard credit to the artist in signage and public communications.
SCHEDULE:
Friday, January 30 @ 9AM
Expression of Interest (EOI) period opens
Friday, March 6 @ 5PM
Expression of Interest (EOI) period closes
Week of March 9
Selection of successful artist
Week of March 16
Kick-off meeting with the artist (pending availability)
Mid-March to May
Design phase*
End of May
Final design due
June to August
Fabrication phase*
September
Sculpture installed on-site of the new hospital
* The design and fabrication phase timelines can be negotiated with the successful artist.
HOW TO SUBMIT:
Please submit your package with the subject:
“DCDH Expression of Interest: Exterior Sculpture – YOUR NAME”
To:
Ashley Pannozzo
DCDH Community Engagement and Communications Liaison
Ashley.pannozzo@northernhealth.ca
250-219-8641
Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks -
Health Care Relocations (HCR) onboarded and getting ready for the big move
Share Health Care Relocations (HCR) onboarded and getting ready for the big move on Facebook Share Health Care Relocations (HCR) onboarded and getting ready for the big move on Twitter Share Health Care Relocations (HCR) onboarded and getting ready for the big move on Linkedin Email Health Care Relocations (HCR) onboarded and getting ready for the big move link
Planning is well underway to ensure a safe and seamless transition for patients, staff, and services when we move into the new hospital.
We’re excited to share that Health Care Relocations (HCR) has been onboarded to guide us through every step of this process.
Health Care Relocations (HCR) is a specialized organization with decades of experience helping hospitals and health facilities relocate efficiently and safely. HCR has been operating since 1993 and has successfully managed over 500 relocations across four continents. Their expertise includes developing relocation strategies, coordinating patient transfers, and minimizing disruption to essential services. Moving into a new hospital is more than packing boxes—it’s a carefully coordinated effort designed to keep patient care at the forefront.
In December, the HCR team was on-site in Dawson Creek to meet with leaders and managers and complete initial departmental walkthroughs. These visits help determine what equipment will move, what needs to be purged or replaced, and how to sequence moves to minimize disruption.
Over the coming months, HCR will develop a move calendar, detailed department move plans, and a move information guide to keep everyone informed.
Staff play a vital role in this process. Department Move Coordinators will be appointed to attend planning meetings, review equipment lists, and provide insights that help shape the move strategy. In addition, a Patient Transfer Committee will be formed to ensure the safe relocation of patients. This team will create transfer day protocols, inpatient information guides, and define team roles and responsibilities for move day.
All of this planning ensures that when the time comes, patients will be transferred with care and dignity—supported by clear communication and well-defined procedures.
Photos from Nats’oojeh Hospital and Health Center mock move day in December 2024

Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks -
FAQ: Parking at the new hospital
Share FAQ: Parking at the new hospital on Facebook Share FAQ: Parking at the new hospital on Twitter Share FAQ: Parking at the new hospital on Linkedin Email FAQ: Parking at the new hospital link
We know parking is important to you! Whether you’re visiting a loved one, coming in for an appointment, or working a shift, having convenient and accessible parking makes a big difference. Here’s what you can expect at the new hospital:
Will there be enough parking at the new hospital?
Absolutely! The new hospital will have 311 parking stalls for staff, physicians, and visitors. This is over 100 additional stalls compared to the current hospital.
Here’s how it breaks down:
- 125 stalls for staff and physicians
- 186 stalls for visitors
- 16 accessible stalls (5 for staff and 11 for visitors)
Plus, 44 stalls will be located close to the Emergency Entrance for quick access when every second counts.
What about special parking needs?
We’ve got those covered too! In addition to the main parking there will be:
- 2 stalls for RCMP near the Emergency Entrance
- Drop-off spaces: 3 at the Main Entrance and 3 at the Emergency Entrance
- Bike racks for 33 employees and 33 visitors
- 8 electric vehicle charging stalls
- Motorcycle parking
- And even parking for light-duty vehicles near the loading dock.
Will parking still be free?
Yes! Parking will remain free for everyone.

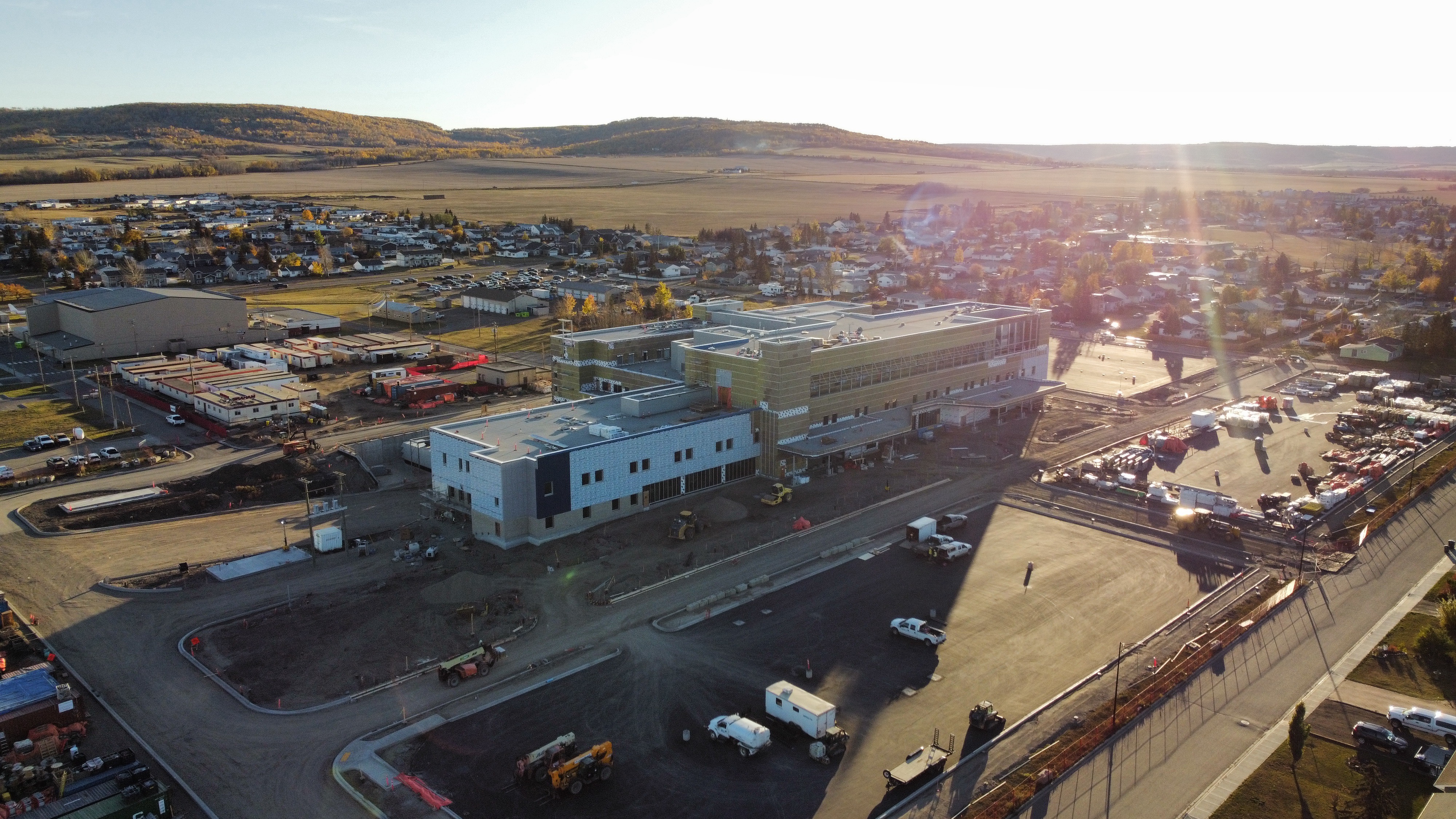

Photo taken: October 9, 2025Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks -
A bright welcome: Tuscan Sun panels complete the hospital’s exterior
Share A bright welcome: Tuscan Sun panels complete the hospital’s exterior on Facebook Share A bright welcome: Tuscan Sun panels complete the hospital’s exterior on Twitter Share A bright welcome: Tuscan Sun panels complete the hospital’s exterior on Linkedin Email A bright welcome: Tuscan Sun panels complete the hospital’s exterior link
The new Dawson Creek and District Hospital continues to transform our skyline – and the latest milestone is hard to miss. Visible from most locations within the city, the reveal of the Tuscan Sun ACM panels adds a warm, golden hue to the building’s exterior.
The warm Tuscan Sun panels complete the hospital’s bold and meaningful exterior colour palette. This vibrant colour isn’t just for looks – it was chosen to complement the City of Dawson Creek’s logo and create a welcoming landmark for patients, families, and visitors. Positioned at the main entrance, the golden panels will help guide people to care while providing a striking contrast to the large “H” sign that will soon be installed.
WATCH: Video of the Tuscan Sun ACM panel reveal

The building now has its full, vibrant look which reflects the beauty and identity of our region:
- Ocean Blue = the vast Peace Region sky
- Lagoon = the northern lights dancing above us
- Tuscan Sun = Dawson Creek pride and a bright beacon for health care
As one of the tallest structures in Dawson Creek, the hospital’s exterior is a symbol of progress, care, and community pride.
Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks -
FAQ: What's going to happen to the current DCDH?
Share FAQ: What's going to happen to the current DCDH? on Facebook Share FAQ: What's going to happen to the current DCDH? on Twitter Share FAQ: What's going to happen to the current DCDH? on Linkedin Email FAQ: What's going to happen to the current DCDH? link
Updated in December 2025 with new information.

Many residents have been wondering what will happen to the current Dawson Creek & District Hospital (DCDH) once the new hospital opens.
Health care services will continue to be delivered at the current hospital while construction is underway on the new hospital – which is expected to be open, operational and ready for patients in Spring 2027.
Now, why are we building a new hospital instead of redeveloping the current one?
The current DCDH was built in 1960 in accordance with clinical health care services and building code standards at the time. Since then, standards have continuously evolved and improved.
Recognizing these changes, the current hospital doesn’t align with current clinical and patient care standards and doesn’t comply with the current BC Building Code. These factors have an impact on patient and family experiences and the delivery of high-quality and efficient care.
There’s also more than what meets the eye when it comes to older buildings such as this. The infrastructure may appear to be in good standing, but it’s what you can’t see that contributes significantly to the need to replace the facility. The current facility has a poor Facility Condition Index, and its age causes deficiencies such as capacity constraints and functional issues.
While some may wonder if the newer section of the current hospital could be retained, this is not feasible. The newer section also does not meet today’s clinical and patient care standards and cannot operate independently. It relies heavily on the older portion of the building for essential mechanical and electrical infrastructure. Key services such as the Emergency Department, Medical Imaging, and Laboratory are interconnected with systems housed in the older section. There is no practical way to sustain only one part of the building without the supporting infrastructure.
The new hospital is going to be a brand-new state-of-the-art facility that is built in compliance with national clinical and patient care standards as well as current design and construction codes.
Northern Health will continue to upgrade equipment and assets in the current hospital to ensure that we’re providing quality health care. Some of the newer equipment and assets that are in good working order will be moved into the new facility during the transition process.
Once the new hospital is open and operational, the current hospital will become inactive, be emptied out and then removed. This step is part of the approved Business Plan, which includes a full abatement process before demolition. Abatement is necessary because older buildings often contain hazardous materials such as asbestos or lead. These materials must be safely removed to protect workers, the community, and the environment, and to ensure the site meets all safety and environmental standards before redevelopment.
In early 2026, Northern Health intends to hire a consultant to prepare materials related to the abatement and demolition of the existing hospital using a procurement process. Following that, a tender process will be held to engage a construction firm to undertake the scope of work. The abatement and demolition of the existing hospital is targeted to take place once the new hospital is open and operational in Spring 2027.
After abatement and removal of the existing facility, the site will be cleared and turned back into developable land for potential future use .
We also acknowledge the tremendous community support over the past years through the Dawson Creek and District Hospital Auxiliary and Foundation who support the fundraising and purchasing of equipment required to improve and enhance health care services within the community.
We recognize that the current hospital has played a significant role in the lives of many staff and residents over the past 60+ years. There are ample memories and stories to be shared and there will be opportunities share those with us in the future to commemorate its legacy.
If you have any ideas or suggestions for legacy projects to commemorate the current hospital, please email LetsTalkDCDH@northernhealth.ca.
Stay tuned for more information!
Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks -
Dawson Creek & District Hospital Foundation Announces Lead Donor for MRI Campaign
Share Dawson Creek & District Hospital Foundation Announces Lead Donor for MRI Campaign on Facebook Share Dawson Creek & District Hospital Foundation Announces Lead Donor for MRI Campaign on Twitter Share Dawson Creek & District Hospital Foundation Announces Lead Donor for MRI Campaign on Linkedin Email Dawson Creek & District Hospital Foundation Announces Lead Donor for MRI Campaign link
The Dawson Creek & District Hospital Foundation is thrilled to announce ARC Resources Ltd. (ARC) as its lead donor in the campaign to bring the first publicly funded MRI machine to the South Peace.
Thanks to a generous contribution of $1.5 million, half of the campaign total, from ARC Resources Ltd., the Foundation is one step closer to reaching its $3 million fundraising goal. This donation marks a pivotal moment in the campaign and reflects the deep commitment of local champions to improving health care access in our region.
“We are incredibly grateful for the early support from ARC Resources,” said Brette Madden, President of the Dawson Creek & District Hospital Foundation. “From the beginning, we knew this goal was ambitious – but essential. ARC’s role in championing this project highlights just how important it is to bring an MRI to the new Dawson Creek Hospital and the difference it will make for our community.”
“We’re proud to be a part of this landmark campaign to enhance access to advanced healthcare in our province,” said Sean Calder, ARC’s Vice President, Field Operations. “Having a new healthcare hub that’s equipped with the latest technology in Dawson Creek will ensure patients can receive timely, high-quality care when they need it – all while staying close to home.”
The MRI will be installed in the new Dawson Creek & District Hospital, a $590-million facility funded by Northern Health and the Peace River Regional Hospital District. The hospital will serve as a modern health care hub for the entire Northeast.
The Foundation continues to seek support from donors across the region to complete this vital campaign.
Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks -
Dawson Creek & District Hospital Foundation launches $3 Million campaign to bring an MRI to the new hospital
Share Dawson Creek & District Hospital Foundation launches $3 Million campaign to bring an MRI to the new hospital on Facebook Share Dawson Creek & District Hospital Foundation launches $3 Million campaign to bring an MRI to the new hospital on Twitter Share Dawson Creek & District Hospital Foundation launches $3 Million campaign to bring an MRI to the new hospital on Linkedin Email Dawson Creek & District Hospital Foundation launches $3 Million campaign to bring an MRI to the new hospital link
The Dawson Creek & District Hospital Foundation is proud to announce the launch of a bold and transformative campaign to raise $3 million to bring the first community-driven and publicly funded Magnetic Resonance Imaging (MRI) machine to the South Peace region.
The campaign, titled “Create a Clear Picture”, will support the purchase of a full body MRI to be installed in the new Dawson Creek and District Hospital, which will be open for patients in Spring 2027.
This landmark initiative reflects the collective efforts and support of residents, organizations, and government partners. This new MRI service will ensure that residents have access to state-of-the-art, publicly funded medical imaging locally, therefore reducing wait times, improving health outcomes, and helping patients avoid long and costly trips to access care elsewhere.
“Having a clear picture—at the right time—is vital for every patient and their family,” said Brette Madden, Chair of the Foundation. “This campaign is about ensuring our community receives the care it deserves, right here at home.”
In addition to improving patient care, the addition of an MRI in the new hospital will play a critical role in attracting and retaining physicians and health care professionals in the South Peace. Access to modern diagnostic tools is a key factor in rural recruitment, and an MRI will help ensure that Dawson Creek remains a competitive and appealing place for health care professionals to start and build their careers.
“Investing in an MRI is vital for our patients,” said Dr. Remi Oyedeji, Chief of Staff at the Dawson Creek and District Hospital. “It will save lives, alleviate pain and anxiety related to travelling for this modality, and help ensure that health care professionals come and stay in our community.”
The new Dawson Creek and District Hospital represents a $590-million investment into health care services in the South Peace and is funded by Northern Health and the Peace River Regional Hospital District. This brand new, state-of-the-art facility will address current and future health and patient care needs and create a model of excellence in health care that incorporates modern best practices and standards. Northern Health has committed $4 million for costs to build the specialized MRI suite and $1.5 million annually for staffing and maintenance costs.
The Foundation invites individuals, businesses, and community partners to join this effort and help create a healthier future for all.
Together, we can Create a Clear Picture.
Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks -
A Project Update: October 2025
Share A Project Update: October 2025 on Facebook Share A Project Update: October 2025 on Twitter Share A Project Update: October 2025 on Linkedin Email A Project Update: October 2025 link
Project status update
Where we’re at
Construction activities are continuing to advance steadily. Interior rough-ins have been completed on Levels 1 and 2, and are progressing on Levels 0, 3, and in the mechanical and electrical rooms. Drywalling, mudding, and taping are actively progressing across all levels, while painting, wall protection, and flooring installations are underway on Levels 1 and 2.
The building envelope continues to take shape with brick veneer, cladding, and ACM panel installation well underway. Site works have also seen significant progress with the south roadway and parking lot asphalt, curb, and gutters now complete.
What’s next
Looking ahead on the exterior, the remaining curb and gutter work and asphalt paving for the north roadway will be completed by November. This will mark the end of paving activities for the year, with final paving and landscaping scheduled to resume in the spring. Work on the exterior envelope will continue through February with cladding progressing throughout the winter months.
On the interior, finishing will continue to ramp up with the installation of fixtures and final finishes, and most drywall work is expected to be completed by the end of the year. The focus will shift to getting the main electrical systems operational, with the goal of having the permanent power energized by the end of the year. Hydronic lines will also begin to be flushed which is a key step in preparing for commissioning activities, which will begin in January with the start-up of the air handling units
Fun facts! Did you know?
The new Dawson Creek & District Hospital is a major infrastructure project, and its scale can be better appreciated when compared to familiar landmarks and distances in the Peace Region:
-
The hospital includes 710 km of branch wiring – which is nearly one-third of the entire Alaska Highway stretching from Dawson Creek to Alaska.
- That same wiring could wrap the ice surface at the Ovintiv Events Centre over 4,000 times.
- Its total weight of 21,000 kg is equivalent to about 30 adult bison, a species native to the Peace Region.
-
The 21 km of feeder wiring is about the driving distance from Dawson Creek to Rolla.
- That feeder wiring also equals 105 laps around the Kenn Borek Aquatic Centre’s 200m indoor track.
- With 10,000 receptacles, the hospital could power every seat in the Ovintiv Events Centre during a sold-out concert, with extras to spare.
- The 405 km of network and low-voltage wiring could stretch along Highway 97 all the way from Dawson Creek to Prince George.
- The 200 km of conduit is equivalent to stacking approximately 1,681 Bear Mountain Wind Park wind turbines end-to-end, each standing about 119 meters tall.
- The 4 km of cable tray is nearly the full length of the Dawson Trail, a 4.5 km community walking path through Kin Park and Rotary Recreation Park.
- The 6,200 light fixtures are enough to install one for every two Dawson Creek residents.
Construction progress photos

Operational readiness and transition planning
Monthly departmental workplan meetings were completed with many programs continuing strong progress defining processes, establishing workflows, and collaborating with other teams to support operational planning.
The third Operational Readiness Committee (ORC) meeting was held August, focusing on discussions around the patient wandering and code white systems, while also addressing risks, reviewing the change request process, and coordinating readiness activities.
Clinical Workshops were conducted the week of Thanksgiving, concentrating on establishing the impact of space and technology changes to key areas such as emergency preparedness, models of care, Vocera communications, building access, and medication administration. Outputs of these sessions will inform policy updates and support staff training and simulation activities planned for next year.
The fourth ORC meeting was held in October, focusing on updates regarding the SaferCare initiative and IMIT scope, while also addressing risks, change requests, and coordination of overall readiness activities.
Engagement initiatives
Cree and Dane-Zaa languages to be featured on select wayfinding signage
We’re proud to share a meaningful milestone in our journey toward truth and reconciliation and cultural safety at the new Dawson Creek & District Hospital. In collaboration with Treaty 8 First Nations, we underwent a thoughtful engagement process to honour their cultural heritage in the new facility. As a result, the Cree and Dane-z̲aa languages will be featured on select wayfinding signage, including department entrances and key destinations.
These languages will also be available on digital wayfinding kiosks, ensuring accessibility beyond physical signage. A dedicated welcome wall in the hospital’s main lobby will celebrate the many Indigenous and global languages spoken in our region – serving as a visual reminder of our shared commitment to inclusion, reconciliation, and cultural safety.
This work reflects the power of partnership and we are grateful to the Elders and Knowledge Keepers who helped shape a facility that reflects the people it serves. The integration of the Cree and Dane-Zaa languages is more than signage – it’s a step toward healing, recognition, and respect.
Mock-up #4: Refining patient care spaces through clinical engagement
We recently completed our fourth mock-up session – this time inside the new hospital! The session focused on a typical medical/surgical inpatient room and a bariatric inpatient room. These hands-on mock-ups allow clinical teams to experience the space and provide real-time feedback before construction is finalized. This collaborative approach helps identify potential issues early and ensures the final design supports both operational efficiency and patient-centered care.
Saulteau First Nations and West Moberly First Nations Health Fair
On September 25, we attended the Saulteau and West Moberly First Nations Health Fair – an event that brought together community members, health professionals, and service providers in a celebration of wellness and connection. We shared updates on the hospital’s culturally inclusive design such as the spiritual room, Indigenous language signage, and the family gathering space. We also distributed employment flyers and had meaningful conversations about future job opportunities. These conversations are vital to ensuring the hospital becomes a place where Indigenous staff, patients, and families feel welcomed, respected, and represented.
Northern Lights College Community Fair
On September 17, we participated in Northern Lights College’s Annual Community Fair at the Dawson Creek campus. With the new hospital being built nearby, the event was a great opportunity to connect with students – especially those pursuing careers in health care. Many nursing students expressed excitement about joining the hospital’s future workforce as we approach our opening in early 2027.
Minister of Health Josie Osborne visits Northeast BC
From August 27–29, Minister of Health Josie Osborne toured Northeast BC to engage with health care professionals and community leaders. During her visit to Dawson Creek, she toured the new hospital site and met with Northern Health Relational Security Officers, Dawson Creek Mayor and Council, and MLA Larry Neufeld. The visit highlighted the hospital’s expanded services and its role in strengthening regional health care.
Other exciting news
Local artists bring the Peace Region to life in the new hospital
The new Dawson Creek & District Hospital is more than just a building – it's a reflection of the land, people, and stories that make our region so special. Through a community call-out, we selected stunning images from local photographers that will be featured as custom wall graphics throughout the facility. These works capture the spirit of Northern BC – from the resilience of the Peace River to the magic of the northern lights, and the quiet beauty of places like Muncho Lake and Dinosaur Lake.
Meet the artists behind the lens – including Bethany-Cerise Buchamer, Darcy Shawchek, Tracy Rondeau, Cameron Alexander, Kevin Xu, Aaron Patrimonio, Don Pettit, and Rick Phillips – and explore how their images will help create a welcoming, healing space for patients, families, and staff.
Retail Food and Beverage Services Opportunity at the New Hospital
Northern Health Authority is conducting an Expression of Interest (EOI) process for the opportunity to operate the café space in the new Dawson Creek and District Hospital.
The successful contractor will provide retail food and beverage services to staff, visitors and the public in the new hospital. The contractor will not be responsible for providing meals for patients.
The café space is approximately 75 square metres (800 square feet) and will operate as a kiosk-style offering, with food prepared off-site and heated on-site. Examples of food offerings include coffee, ready-to-eat meals such as soup, sandwiches, salads, tea, etc. The food offerings shall include a variety of fresh, affordable and healthy food items for a broad range of customer needs.
Interested? Applicants are required to submit a proposal following the instructions outlined in the Expression of Interest - Retail Food and Beverage Services - Dawson Creek and District Hospital document.
You can also access and view the opportunity on BC Bid: BC Bid - Expression of Interest - Retail Food and Beverage Services - Dawson Creek and District Hospital
Featured stories:
- The artists behind the images featured throughout the new hospital
- Community Connections: September Engagement Highlights
- Integrating the Cree and Dane-zaa languages into wayfinding signage in the new Dawson Creek & District Hospital
- Minister of Health Josie Osborne visits Northeast BC
- Mock-up #4: Refining patient care spaces through clinical engagement
- A Project Update: July 2025
- FAQ: What is Northern Health doing to recruit and retain staff for the new Dawson Creek & District Hospital?
- Quarterly Update - July 2025 [PDF]
- Monthly labour report - As of September 30, 2025 [PDF]
- Monthly labour report - As of August 30, 2025 [PDF]
- Monthly labour report - As of July 31, 2025 [PDF]
- Construction Camera Timelapse - September 2025 [VIDEO]
- Construction Camera Timelapse - August 2025 [VIDEO]
- Construction Camera Timelapse - July 2025 [VIDEO]
Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks -
The hospital includes 710 km of branch wiring – which is nearly one-third of the entire Alaska Highway stretching from Dawson Creek to Alaska.
-
Expression of Interest - Retail Food and Beverage Services
Share Expression of Interest - Retail Food and Beverage Services on Facebook Share Expression of Interest - Retail Food and Beverage Services on Twitter Share Expression of Interest - Retail Food and Beverage Services on Linkedin Email Expression of Interest - Retail Food and Beverage Services link
Northern Health Authority is conducting an Expression of Interest (EOI) process to advertise the upcoming opportunity to operate the café space in the new Dawson Creek and District Hospital and assess the level of market interest. This EOI invites interested parties to submit proposals to express interest in providing retail food services to staff, visitors and the public at the Hospital.
The successful contractor will provide retail food and beverage services to staff, visitors, and the public in the new hospital. The contractor will not be responsible for providing meals for patients.
The café space is approximately 75 square metres (800 square feet) and will operate as a kiosk-style offering, with food prepared off-site and heated on-site. Examples of food offerings include coffee, ready-to-eat meals such as soup, sandwiches, salads, tea, etc. The food offerings shall include a variety of fresh, affordable and healthy food items for a broad range of customer needs.
The following is the estimated timeline for the EOI process. All dates in the timeline are subject to change at the discretion of the Authority.
Activity
Timeline
EOI issue date
October 31, 2025
Question submission deadline
January 14, 2026
EOI closes – Proposal submission due
2:00 PM MST on January 16, 2026
Interested? Applicants are required to submit a proposal following the instructions outlined in the Expression of Interest - Retail Food and Beverage Services - Dawson Creek and District Hospital document.
You can also access and view the opportunity on BC Bid: BC Bid - Expression of Interest - Retail Food and Beverage Services - Dawson Creek and District Hospital

Thank you for your contribution!
Help us reach out to more people in the community
Share this with family and friends
No thanks
